Minimum vertical clearance from the river to the bridge girders for large vessels within the navigation channel
Total bridge length
Height of the two pylons
Distance between main span pylons
Total length of cable-stayed main span

Foundation Piles Completed

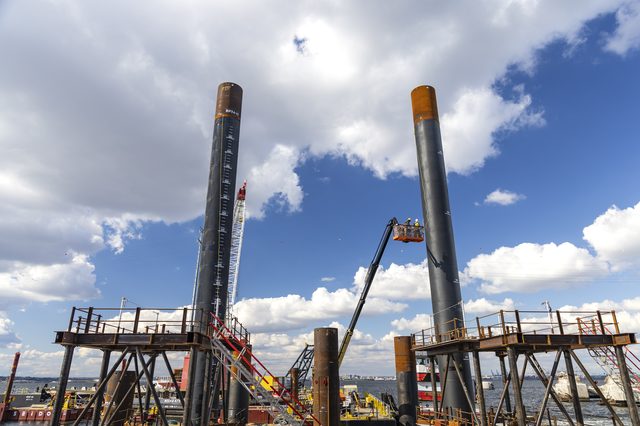

The foundation piles for the north and south pylons are hollow steel pipes – over 200 feet long and 8 feet in diameter driven deep into the riverbed to support the bridge foundation.
Completion of foundation piles installation for the North Pylon (Pier 25) anticipated Winter 2027.
Pier Protection Piles Completed
The pier protection piles for the north and south pylons are hollow steel pipes – over 200 feet long and 8 feet in diameter driven deep into the riverbed to support the pier protection fender.
Completion of pier protection piles installation for the North Pylon (Pier 25) anticipated Winter 2027.

Foundation Piles Completed
The foundation piles for the north and south pylons are hollow steel pipes – over 200 feet long and 8 feet in diameter driven deep into the riverbed to support the bridge foundation.
Completion of foundation piles installation for the South Pylon (Pier 24) anticipated Winter 2027.
Pier Protection Piles Completed
The pier protection piles for the north and south pylons are hollow steel pipes – over 200 feet long and 8 feet in diameter driven deep into the riverbed to support the pier protection fender.
Completion of pier protection piles installation for the South Pylon (Pier 24) anticipated Winter 2027.
Completed October 2026
Completed October 2026
Completed February 2026
Completed February 2026
Completed July 2025

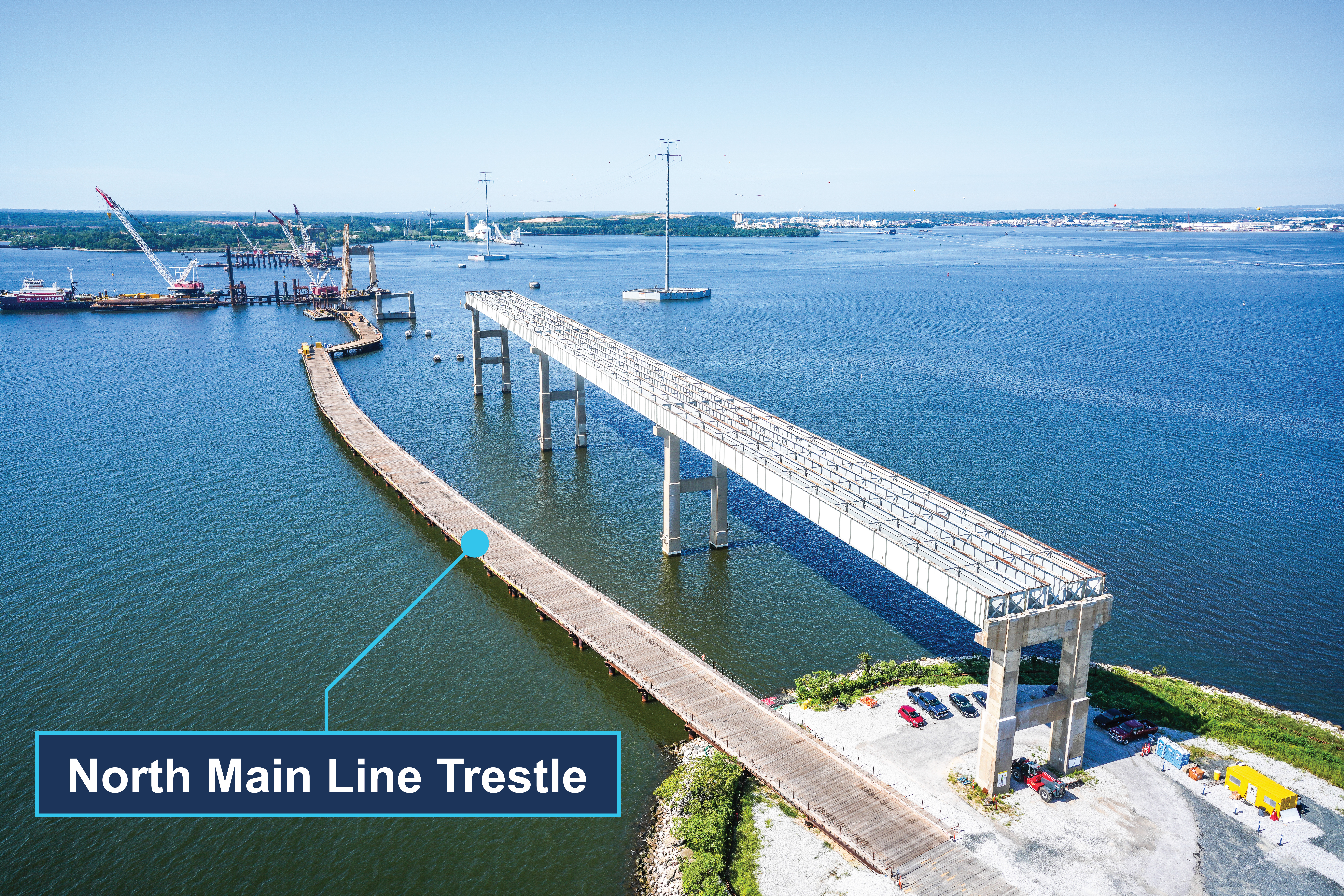

Construction of the North Main Line Trestle (Work Platform) was completed in October 2026. The Work Platform is temporary structure made of 36″ steel pipe piles, steel girders, and a timber mat surface that provides direct access from land to the bridge piers for construction crews, materials and cranes. Once construction is complete, the work platforms will be removed and reused/recycled.

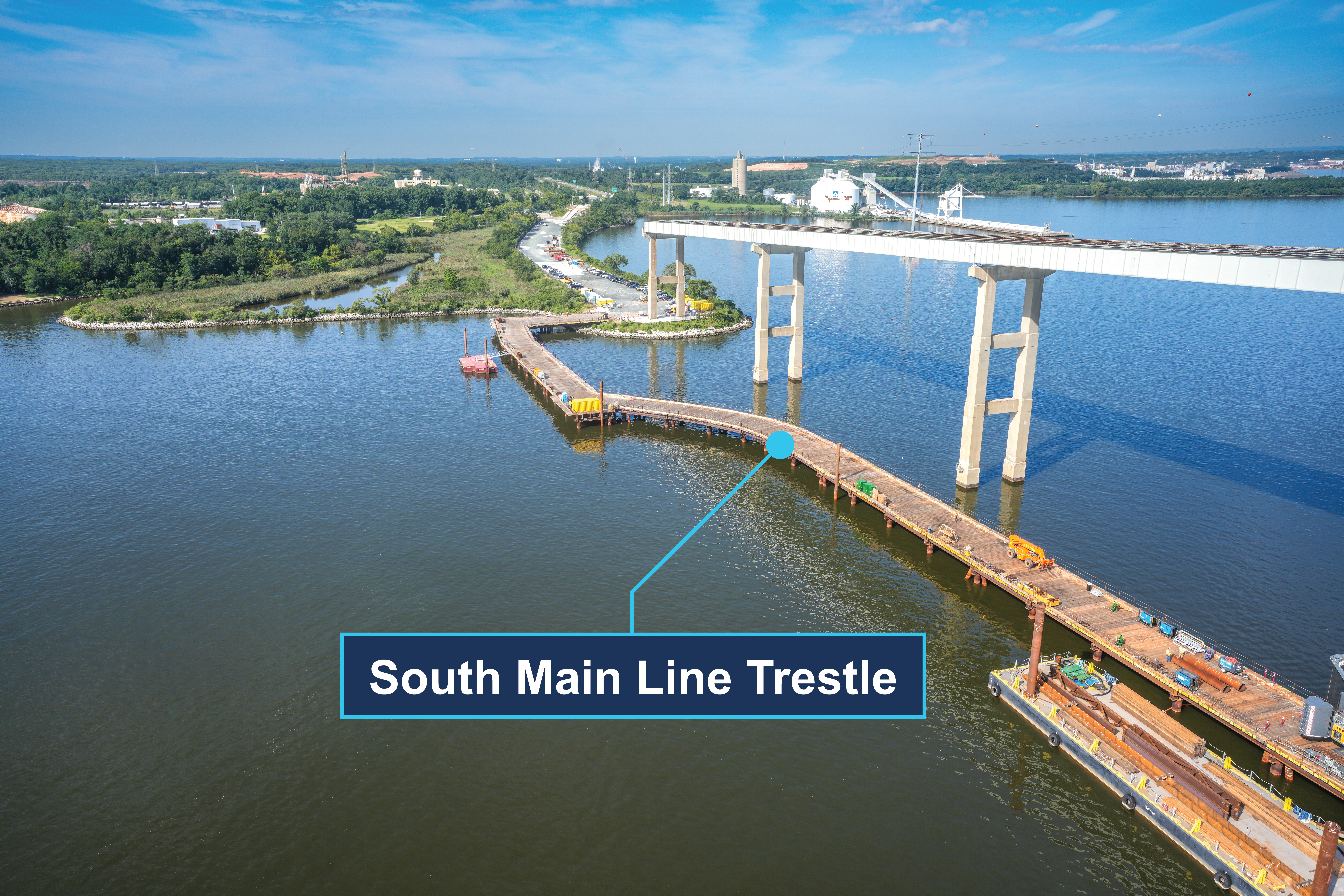

Construction of the South Main Line Trestle (Work Platform) was completed in October 2026. The Work Platform is temporary structure made of 36″ steel pipe piles, steel girders, and a timber mat surface that provides direct access from land to the bridge piers for construction crews, materials and cranes. Once construction is complete, the work platforms will be removed and reused/recycled.

The Test Pile Program was successfully completed in February 2026, confirming the strength and performance of the project’s foundation design and allowing the team to move directly into driving permanent piles. The test piles were 8 feet in diameter and over 200 feet long.

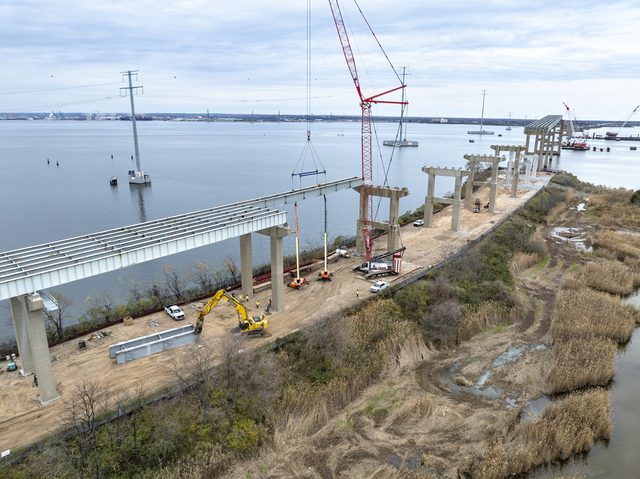

Demolition of the existing bridges over land was completed in February 2026. On land, the team removed 20,000 tons of concrete decking and concrete columns, along with 160 steel girders on both the north and south sides of the bridge.
Pre-construction activities were completed in July 2025. Activities included wind tunnel testing, survey & mapping, scour testing, property inspections, bridge alignment and geotechnical investigations.
The Federal Highway Administration (FHWA) approved the Categorical Exclusion (CE) for the Key Bridge Rebuild Project in July 2024. The CE confirms that the project will restore a critical interstate transportation link while avoiding significant impacts to nearby communities and natural or cultural resources. The project is expected to have substantial transportation and socioeconomic benefits and WILL NOT:
Completion of the North Main Line Trestle (Work Platform).
Completion of the South Main Line Trestle (Work Platform).
Advertised for the Main Span & Marine Approaches Request for Qualified proposers.
Bids opened for the Demolition & Miscellaneous Marine Work bids.
Continue driving permanent foundation piles and pier protection piles at the South Pylon (Pier 24).
Continue driving permanent foundation piles and pier protection piles at the North Pylon (Pier 25).
Award for the Demolition and Miscellaneous Marine Work contract.
